Installation is where a cantilever scaffold either earns its rating or quietly sets up a failure. Most problems we're called about trace back to two habits: loading the scaffold before the anchor concrete has reached strength, or skipping the tie-rod and propping step to save a day. Neither shows up until there's weight on the frame.
This is the sequence we hand our own crews and customers for the modern embedded tie-rod system. Treat it as the working baseline behind a project-specific design, not a replacement for one. Cantilever scaffolding is an engineered structure everywhere it's used, and the drawings and load calc always come first.
Before you start: what has to be ready
You need an approved construction plan on site before a single beam goes up. Cantilever and knee-out scaffolds carry an eccentric load, so many jurisdictions require them to be built under a competent erector and checked by two competent scaffold inspectors, not one. Confirm the design document is signed off and the erection method is spelled out.
Then check the kit. Every beam, rod, and fitting should be free of bends, rust, and cracks. Verify three things match the drawing: the beam size, the tie-rod diameter, and the fit between the embedded insert and the bolt you'll thread into it weeks later. A mismatched insert is the single most expensive thing to discover after the pour.
Embedded parts have to be cast in the right spots, numbered to the drawing. That includes the lower insert the beam bolts to, and the 145 mm upper insert for the tie rod, which goes in before the floor above is poured.
Concrete strength gates are the part crews skip and shouldn't. Each step below has a minimum strength the host concrete must reach first:
| Step | Minimum concrete strength before you proceed |
|---|---|
| Install the double-head embed screw | ≥5 MPa |
| Install the cantilever I-beam (host structure) | ≥C10 |
| Erect the scaffold on the beams | ≥C15 |
| Tension the upper tie rod (upper anchor point) | 75% of design strength (roughly 72 hours after the pour) |
The erection sequence, step by step
- Mark and position. Set out the standard spacing from the plan with proper measuring tools. The beam and standard positions are load points, so precision here pays off all the way up.

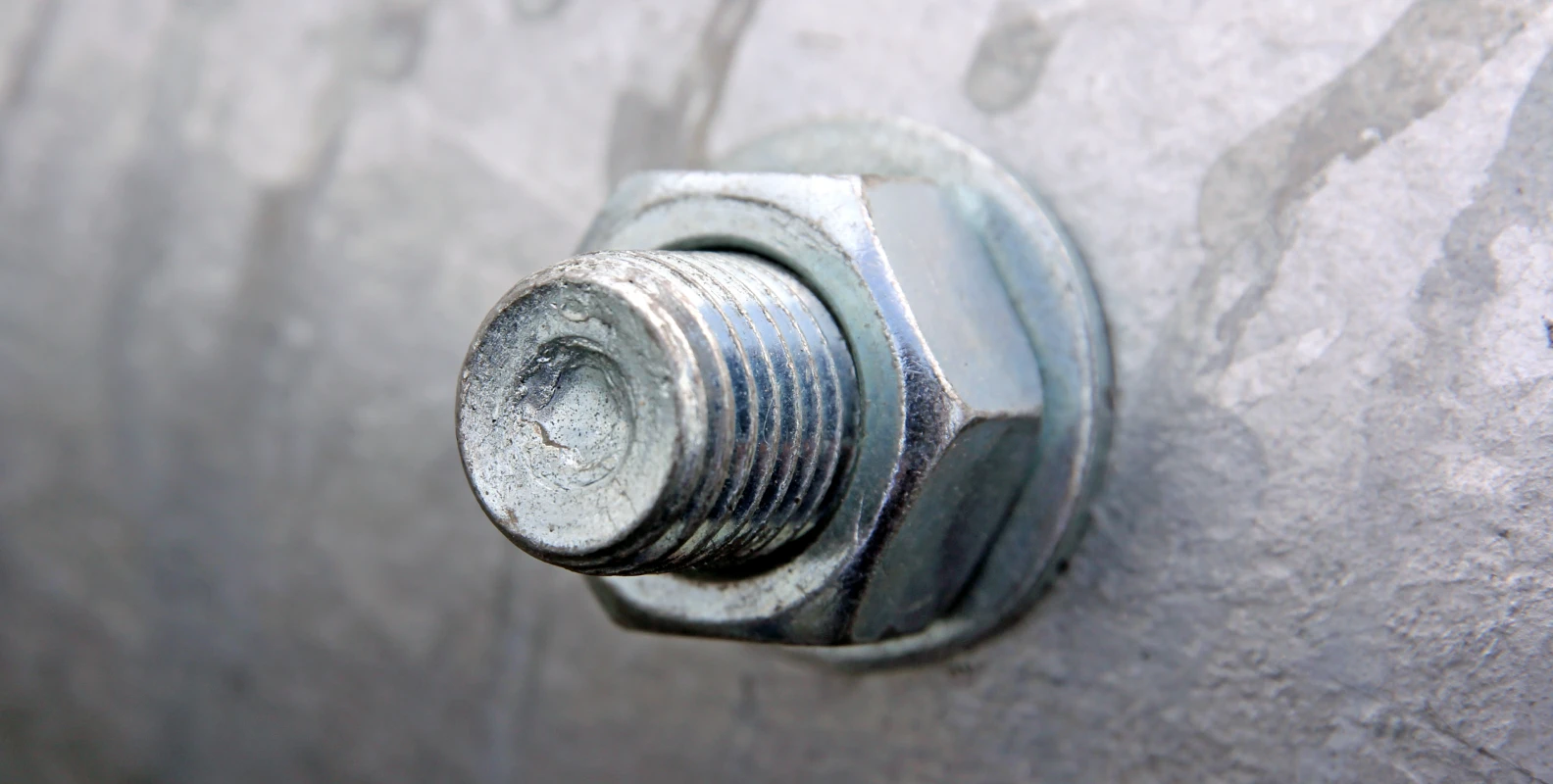

- Fit the embed bolts. Once the concrete is at 5 MPa or higher, install the double-head screw into the insert. You can't see the inside connection, so read the exposed thread length to confirm it's seated and safe.

- Set the cantilever I-beam. Seat the underside tight against the concrete wall or beam. The outer end has to sit 1-2 cm high; it must never droop down. If it drops, shim the base plate until it lifts. Place each beam by its drawing number, and cap the protective covers straight after so the nut and screw threads don't corrode or get fouled by concrete. Host concrete should be C10 or higher. Where beams meet at a corner or project past 1.5 m, weld both beams and add 200×200×10 mm reinforcement plates top and bottom, with full welds and no air holes or slag. H-section steel is used in place of the I-beam where the calc calls for more capacity.
- Fix the standards. Lock the vertical rods to the beam layer with positioning pins, then stand them up.
- Build the frame. Run the longitudinal and transverse sweep rods, then the longitudinal and transverse horizontal rods, joining tubes with swivel and double couplers.
- Tie in and brace. Fit the wall connectors and diagonal braces per the plan.
- Enclose the working layer. Hang the safety nets, tie the color bands, and lay the boards and toe boards.
- Do the tie-rod step before you go higher. This is the gate that keeps the beam from rotating. Until the upper tie rod is in, cap the scaffold at 10 m, and never more than half the total frame height. On super-long beams over 1.8 m, prop or backstay the beam with a steel pipe or an adjustable steel prop before erecting, and pull the prop only after the tie rod is tight. Once the floor above reaches 75% strength and the outer formwork is stripped, connect the twin-ear anchor into the 145 mm insert, pin the diagonal tie rod with its axle pin, and tension the turnbuckle to load state. From there you can carry the section up to within 20 m, then re-cantilever a new beam layer above.

Getting the tie-rod tension right
Set the diagonal tie rod at 45° or steeper to the horizontal beam, and tension the turnbuckle to a torque of 110 N·m. That's the number that lifts the beam's outer end into load and takes the weight off the temporary prop. Leave it slack and the beam sags under the scaffold; the target is the spec, reached and checked, not "as tight as it'll go." Once the rod is carrying, the prop comes out and the beam is standing on its two designed connections: the bolt at the wall and the tie rod above.
Inspect before first use
A competent person inspects the scaffold before the first shift and after anything that could affect it, weather included. For a cantilever setup, that means two competent inspectors. Walk this list:
- Approved plan on site; beam layout matches the drawing
- Beam tail anchored at two or more points to the RC beam or slab, using U-loops or bolts of 16 mm or thicker
- Beam outer end sitting 1-2 cm high; underside tight to the concrete
- Tie rod pinned and tensioned; protective caps on the embed threads
- Standards plumb; wall connectors and braces tight
- Full planking with gaps under 25 mm; boards overhang supports 150-300 mm and no more than 460 mm
- Guardrails at 0.9-1.2 m plus toe boards; safety nets hung; no loose debris or standing water
- Load kept within the rated capacity, and never staged on the beam or scaffold during erection
Two field rules worth repeating: don't stack heavy material on the cantilever beam while you're still building, and don't crane loads onto the scaffold before it's tied and rated. If you're staging material at height, do it through a proper material loading platform, not the working scaffold. And in rain or high wind, stop.
Dismantling: reverse the logic, from the top down
Take the scaffold apart top down. There's no aerial dismantling, and each cantilever tier comes off in reverse order of how it went up: last built, first removed. The clean sequence for one beam layer is:
- Strip the frame down to the tie-rod layer
- Loosen the tie rod
- Pull the axle pin
- Remove the tie rod
- Remove the twin-ear anchor
- Strip the frame down to the I-beam layer
- Move the I-beam clear of the frame
- Off the tier below, build a 1.2 m temporary single-row outer frame as fall protection to work that beam layer
- Remove the nut cap, then the nut and washer, then the I-beam, then the high-strength screw
- Repeat on the layer below
Sort, stack, and code the removed beams, rods, turnbuckles, and pins by size as they come down, and ship them out on plan. This is the step that turns the modern kit into money back: because the parts came off bolted and clean, they go straight to the next job instead of the scrap bin. For the full picture of how the system is put together and why it's built this way, see our cantilever scaffolding systems guide.

Install mistakes we see most
- Loading the scaffold before the anchor concrete reaches C15
- Beam outer end drooping instead of set 1-2 cm high
- Skipping the prop on beams over 1.8 m before the tie rod is tensioned
- Leaving the protective caps off, so the threads corrode and won't adjust later
- Casting the wrong insert, so the beam bolt won't thread in
- Running one section past 20 m instead of re-cantilevering
How long installation actually takes: a realistic crew plan
Buyers rarely ask about installation time, yet it decides whether the scaffold is ahead of the concrete cycle or behind it. For planning purposes, a trained crew of four to six scaffolders plus one lift operator handles one beam layer on a typical residential floor plate in one to two working days, depending on corner count. Erecting the tube-and-coupler section above it runs at roughly the speed of any conventional scaffold, around 80 to 120 m² of facade per crew per day once the first lift is set. The bottleneck is never the beams; it is the wait for concrete strength and the rhythm of the tower crane.
A sensible schedule for one tier looks like this:
| Stage | Crew | Typical duration |
|---|---|---|
| Marking sleeve positions and casting inserts with the slab pour | 2 fitters with the concrete crew | Same shift as the slab |
| Waiting for anchor concrete strength (75% of design, about 72 hours at normal curing) | - | 3 days minimum |
| Setting and torquing the beam layer | 4-6 scaffolders | 1-2 days per floor plate |
| Erecting standards, ledgers, platforms to first lift | 4-6 scaffolders | 2-3 days per lift |
| Tensioning tie rods and final inspection before loading | 2 scaffolders + competent inspector | Half to one day |
The cantilever scaffolding guide covers the system design side; this schedule is the field side of the same logic.
What a complete installation kit should contain
Before erection starts, lay the kit out at ground level and count it against the layout drawing. A complete cantilever tier normally comprises the I-beams in straight, corner, and diagonal lengths, the cast-in sleeves and anchor hardware, the tie-rod sets with turnbuckles and twin-ear anchors, the beam-end positioning pins, and the torquing fasteners counted per beam. Missing any single category stops the sequence cold, and the missing piece is always discovered at height. A proper cantilever scaffolding package arrives with the bill of quantities keyed to the layout positions, so the ground count doubles as the first quality check of the whole installation.
Tools and small equipment that decide installation quality
Most of the hardware arrives in the kit, but a short list of site tools separates a compliant installation from a loose one. A calibrated torque wrench in the 40-65 N·m range for tie-rod and anchor nuts, with the calibration certificate on site, is the single most important item; guesswork tightening is how undersized tension passes unnoticed. Add a spirit level or laser for beam seating, spanners matched to the nut series actually delivered (mixed batches of nut sizes cause real delays), a grease gun for threads that will be stripped and reused later, and tag lines for controlling beams during crane lifts. For the frame itself, keep a bin of rated double couplers and swivel couplers at the working level so erectors never improvise a connection with the wrong fitting because the right one is two floors down.
Weather and concrete gates you should not waive
Two gates protect the whole sequence. The concrete gate: anchors and sleeves reach working strength only when the slab does, which is why the 72-hour, 75%-strength rule exists. Pulling tie rods against green concrete crushes the anchor zone locally, and the damage stays hidden until the beam is fully loaded. The weather gate: stop beam lifts and deck work when wind at height exceeds what the crew can control, and never leave a partially tensioned tier overnight in a storm forecast. Rain itself is workable; wind combined with unsecured material is not. Sites that log these two gates daily - concrete cube results and wind readings - build the evidence trail that turns an inspection from an argument into a formality.
Working around corners, openings, and the tower crane
Straight runs install themselves; the layout earns its keep at the exceptions. At outside corners, set the corner beams first and pull straight-run spacing from them, because corner geometry fixes the rest of the layer. At window and balcony openings, the beam passes the opening and anchors on the far side, which means the sleeve position has to be cast before anyone knows the final trim - coordinate with the facade drawings at pour stage, not at beam stage. Around the tower crane zone, leave the beams off entirely within the tie-in collar width and bridge the gap with a short independent bay; trying to cantilever around a live crane tie creates a conflict that someone will eventually "solve" with an unauthorized weld. Where a temporary working platform is needed below an open edge during beam setting, an adjustable steel prop under the beam tip - for beams over 1.8 m - is the standard temporary measure until the tie rod takes the load.
The leapfrog sequence: reusing one kit up the whole tower
A cantilever scaffold earns its price by moving. Instead of buying material for every tier, most crews run two beam-and-frame kits in a leapfrog rhythm: while tier B above is being loaded and worked, tier A below is stripped, cleaned, and lifted past it to become tier C. The concrete cycle sets the pace - each new beam layer must wait for its own 72-hour strength gate - so with a typical one-floor-per-week structural rhythm, two kits comfortably serve a continuous climb, and three kits give margin for weather delays or a second facade front.
Three habits keep the leapfrog efficient. Sort and code every component as it comes down, so the next layer goes up without measuring and hunting; a color code per length pays for itself in the first move. Inspect threads, sleeves, and turnbuckle bodies at ground level between moves, when replacement is cheap, rather than at height with the crane waiting. And keep the fastening hardware - nuts, washers, pin clips - as a counted set per beam, because small parts are where leapfrog kits quietly bleed inventory. Contractors who skip this discipline end up buying a third kit not for speed, but to replace what the first two lost.
Handover documentation to demand from the installer
The installation is finished when the paperwork exists, not when the last plank is down. A complete handover package for one tier contains the as-built beam layout drawing with positions numbered, the concrete strength evidence for every anchor pour, the torque log with wrench calibration reference, the pre-use inspection record signed by the competent person, and the component identification for the beams and tie rods actually installed. This package is what an insurer, a safety officer, or a project auditor asks for after any incident, and it is far easier to collect during erection than to reconstruct afterward. On multi-tier towers, keep one folder per tier and number the tiers consistently with the layout drawings, so any beam on the building can be traced back to its batch, its pour date, and its inspection record in under a minute.
Get a matched kit with install support
We manufacture cantilever beams and the full anchoring kit, and we supply the drawings and torque figures with the hardware so your crew installs it right the first time. Send us the building height, floor cycle, and facade, and we'll match beams, tie rods, turnbuckles, anchors, and pins in custom lengths, with test reports. Samples and OEM supply are available through our contact page.
Frequently asked questions
When can I start erecting scaffold on the cantilever beams?
After the host structure concrete reaches C15. Two earlier gates apply first: the double-head embed screw goes in once concrete is at 5 MPa, and the I-beam is set once the host structure is at C10. The upper tie rod is tensioned only after the anchor above reaches 75% of design strength, usually around 72 hours after the pour.
Why does the beam's outer end have to tilt up 1-2 cm?
Because the scaffold load will push that end down. Setting it 1-2 cm high leaves room for that deflection so the beam ends up close to level under load. A beam that already droops before loading is a sign the seating is wrong, and it needs a steel shim under the base plate before you go on.
What torque should the tie rod be tensioned to?
110 N·m, with the rod set at 45° or steeper to the horizontal beam. That tension carries the beam's outer end and lets you pull the temporary prop. Tension to the spec and check it; more than the spec isn't the goal.
Do I always need to prop the beam during erection?
Only for super-long beams over 1.8 m. Those get a steel pipe or adjustable prop under them before the scaffold goes up, and the prop stays until the tie rod is tightened. Shorter beams don't need it once the anchor and tie rod are in.
How high can one cantilever section go before re-cantilevering?
A single section runs up to within about 20 m. Before the tie rod is installed, keep it under 10 m and no more than half the total frame height. For taller buildings, fix a new beam layer every few floors and start a fresh section.
Who is allowed to install and inspect it?
Only trained, certified scaffolders should erect, alter, or dismantle it. Inspection is done by a competent person before the first shift and after any event that could affect the frame; because it's a cantilever, that inspection needs two competent inspectors.
What is the dismantling order?
Top down, reversing the build: strip to the tie-rod layer, loosen and remove the tie rod and twin-ear anchor, strip to the beam layer, then remove the nut cap, nut, washer, I-beam, and screw. No section is dismantled from the air, and parts are sorted and coded by size as they come off.
-
